properties on the U.S. side of the
 project for the new international
 bridge crossing between the two
 countries, to be jointly owned by
 Canada and Michigan, and paid for
 entirely by Canada.
 In 2018,  under  a P3 agreement,
 Bridging North  America (BNA)
 Constructors Canada GP joint
 venture (JV)  won the $5.7 billion
 fixed-price contract to design, build,
 finance,  operate  and  maintain  the
 publicly-owned facilities for 30
 years. Comprising  Aecon, Fluor
 and ACS Infrastructure (the parent
 company of constructors Dragados-
 Canada and Dragados-USA), the  JV
 began construction that October
 on the project’s four components:
 the bridge itself, the Canadian
 entry point and customs plazas, the
 U.S. entry point and the Michigan
 interchange  linking the bridge to
 Interstate 75.
 Scheduled to open in late 2024 for
 truck traffic, the 2.5-kilometre-long
 Gordie Howe International Bridge,
 named to honour the beloved Detroit
 Redwing,  one  of  hockey’s  all-time
 greats, will be among the five longest
 bridges in North America, and built
 to accommodate three Canadianbound
 and three U.S.-bound  lanes
 for cars and commercial traffic, and
 a dedicated multi-use path for pedestrians
 and  cyclists.  The  Windsor
 port of entry  will be the  largest
 along the Canada-U.S. border, and
 the U.S. port of entry one of North
 America’s largest.
 North America’s longest
 cable-stayed main span
 Stringent  environmental  studies
 on both sides influenced the  location
 of  all  four  components  of  the
 P3 project, says Mark Butler, BNA’s
 director of communications. Most
 importantly,  environmental  concerns
 helped dictate the choice of
 the cable-stayed design, he says,
 since building the towers in the
 water  might  have  impacted  boat
 navigation, fish migration and water
 quality, and only a suspension or
 cable-stayed bridge could have been
 built for such a long span. In fact, at
 853 metres across the Detroit River,
 the main span  will be the  longest
 of any cable-stayed bridge in North
 America. Further, at 227 metres, the
 two bridge towers will rival the tallest
 tower in Detroit’s downtown, the
 GM Renaissance Center.
 The two main towers, from
 which the cables extend to support
 the bridge deck, each rise from the
 ground on two  wishbone-shaped
 footings, before ascending as spires.
 Each of the tower  footings require
 six piles, three metres in diameter,
 and three pairs of side span piers to
 transfer main span  loads from the
 backstay cables to the ground. BNA
 subcontracted GFL Infrastructure
 for the foundation  work on the
 Canadian side. Malcolm Drilling was
 the foundation subcontractor on the
 U.S. side.
 “The requirements for this project’s
 longevity  were  a  minimum
 of 125 years, so every  little bit of it
 needed to undergo a massive amount
 of scrutiny,” said Justin Beaveridge,
 Dragados-Canada’s  tower/foundations
 engineer. “As part of the
 contractual  requirements,  every
 COVER STORY
 CONTINUED ON PAGE 10

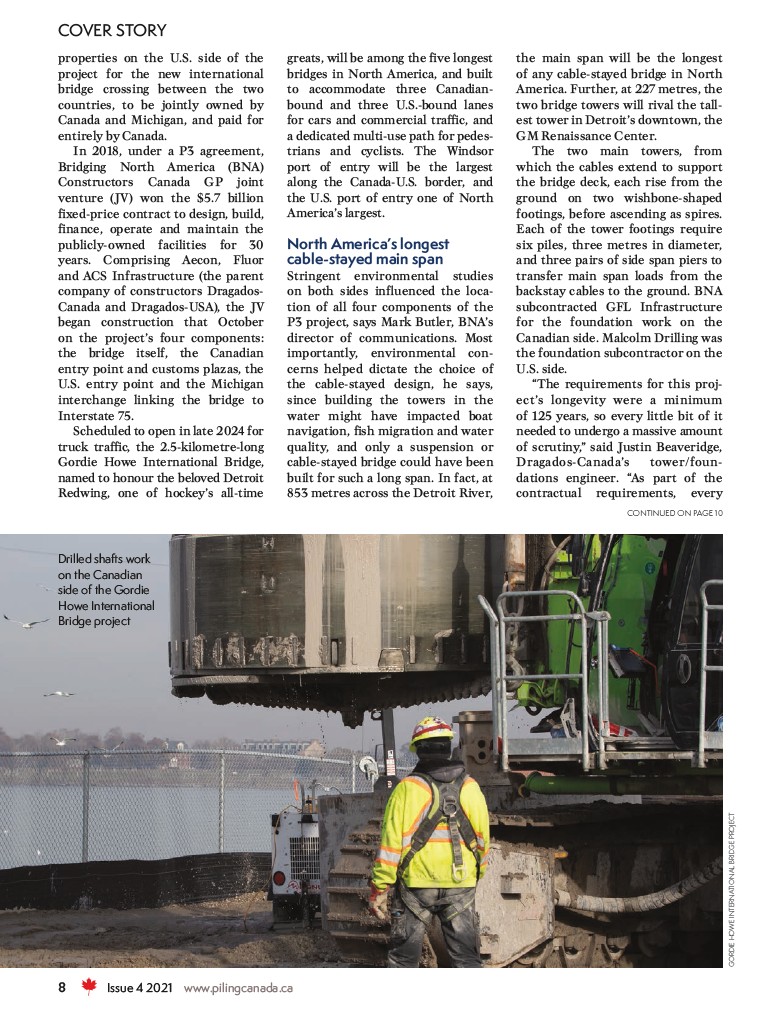

 Drilled shafts work
 on the Canadian
 side of the Gordie
 Howe International
 Bridge project
 GORDIE HOWE INTERNATIONAL BRIDGE PROJECT
 8 Issue 4 2021  www.pilingcanada.ca


/www.pilingcanada.ca
